ID
0011603
TypeCategorySeverityReproducibilityDate SubmittedLast Update
defect[Openbravo ERP] 03. Procurement managementminoralways2009-12-02 13:042017-05-29 13:45
ReporterRenateNieuwkoopView Statuspublic
Assigned ToTriage Omni OMS
PrioritynormalResolutionopenFixed in Version
StatusscheduledFix in branchpiFixed in SCM revision
ProjectionnoneETAnoneTarget Version
OSAnyDatabasePostgreSQLJava version
OS VersionDatabase versionAnt version
Product Version2.50MP8SCM revision
Review Assigned To
Web browser
ModulesCore
Regression level
Regression date
Regression introduced in release
Regression introduced by commit
Triggers an Emergency PackNo
Summary

0011603: PO Created by MRP: Order date on the lines is incorrect

DescriptionProcurement Management || Transactions || Purchase Order || Header >> Lines

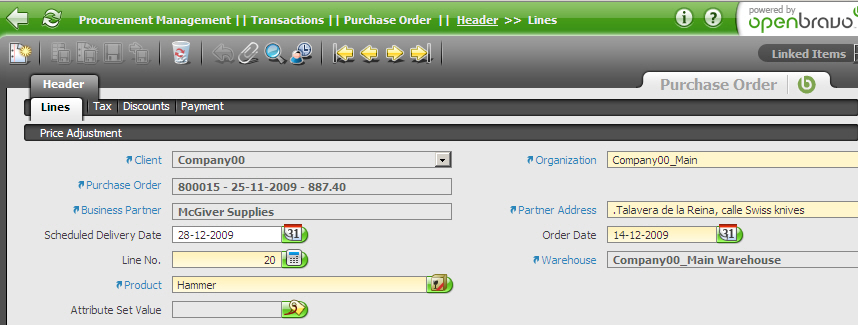

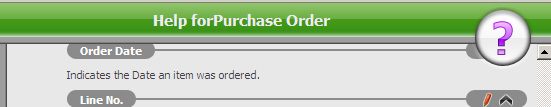

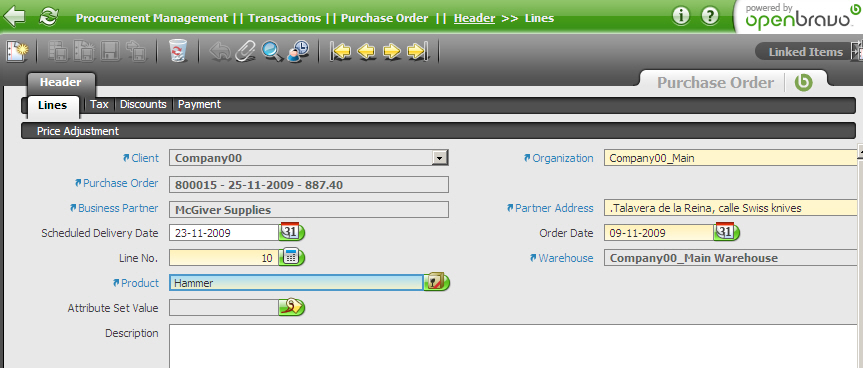

The Purchase Order created by MRP has incorrect Order dates on the lines. The order date is being calculated by taking the Scheduled Delivery Date minus the Purchasing lead time. This can result in dates in the past or in the future (see snapshots), while the definition of the field in the help function states that the order date is the date that the order was added. So the order date should be like at the header level: the date that MRP created that Purchase Order.

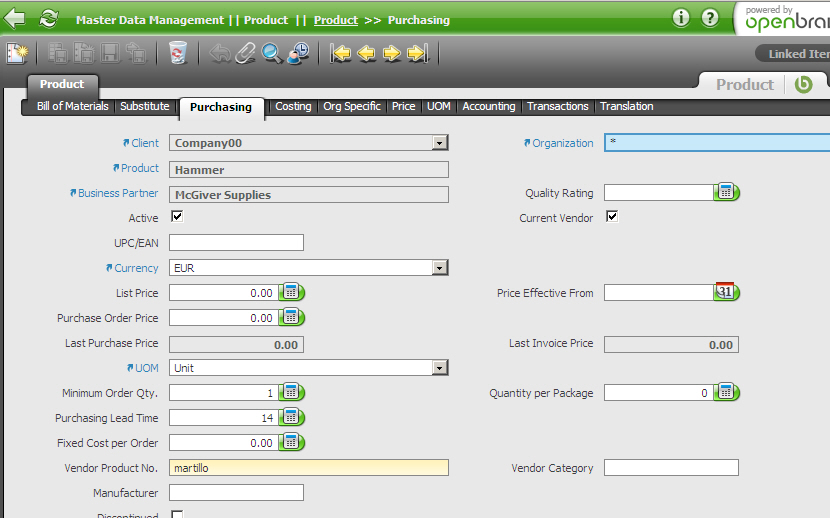

Steps To ReproduceAdd a product with a purchasing leadtime of 14 days (in our case 'hammer') and safety stock of 1000. Min order qty is 500, quantity type mulitple of 500.

Enter a Sales Order for 5 weeks from now for qty 350.

Enter a Planning method for inclusion of the Purchase Order and Sales Order.

Set up a Purchasing Plan for a horizon of 60 days for hammer.

Process the Purchase Plan and create the PO.
TagsOB3 Documentation, VMA-Reviewed
Attached Filesjpg file icon 02120OrderDatePO1.jpg [^] (36,961 bytes) 2009-12-02 13:04

jpg file icon 02120OrderDatePO2.jpg [^] (164,367 bytes) 2009-12-02 13:05

jpg file icon 02120OrderDatePO3.jpg [^] (174,601 bytes) 2009-12-02 13:06

jpg file icon 02120OrderDatePO4.jpg [^] (195,212 bytes) 2009-12-02 13:06

jpg file icon 021209LTHammer.jpg [^] (198,705 bytes) 2009-12-02 13:06

- Relationships Relation Graph ] Dependency Graph ]
blocks defect 00196353.0MP10 closedumartirena MRP: Scheduled delivery date on PO is not in sync with the Planned Order Date in the Purchasing Plan

-  Notes
There are no notes attached to this issue.

- Issue History
Date Modified Username Field Change
2009-12-02 13:04 RenateNieuwkoop New Issue
2009-12-02 13:04 RenateNieuwkoop Assigned To => rafaroda
2009-12-02 13:04 RenateNieuwkoop File Added: 02120OrderDatePO1.jpg
2009-12-02 13:05 RenateNieuwkoop File Added: 02120OrderDatePO2.jpg
2009-12-02 13:06 RenateNieuwkoop File Added: 02120OrderDatePO3.jpg
2009-12-02 13:06 RenateNieuwkoop File Added: 02120OrderDatePO4.jpg
2009-12-02 13:06 RenateNieuwkoop File Added: 021209LTHammer.jpg
2010-02-11 17:56 rafaroda Assigned To rafaroda => adrianromero
2011-06-03 11:00 dalsasua Assigned To adrianromero => dalsasua
2011-07-20 18:11 dalsasua Assigned To dalsasua => jonalegriaesarte
2012-02-02 13:09 RenateNieuwkoop Tag Attached: OB3 Documentation
2012-02-02 18:38 jonalegriaesarte Relationship added blocks 0019635
2012-04-03 12:20 jonalegriaesarte Assigned To jonalegriaesarte => vmromanos
2012-04-11 11:06 vmromanos Tag Attached: VMA-Reviewed
2012-04-17 08:45 Sandrahuguet Assigned To vmromanos => Sandrahuguet
2012-04-17 08:57 Sandrahuguet Status new => scheduled
2012-04-17 08:57 Sandrahuguet fix_in_branch => pi
2017-05-29 13:45 Sandrahuguet Assigned To Sandrahuguet => Triage Finance

Copyright © 2000 - 2009 MantisBT Group
Powered by Mantis Bugtracker
